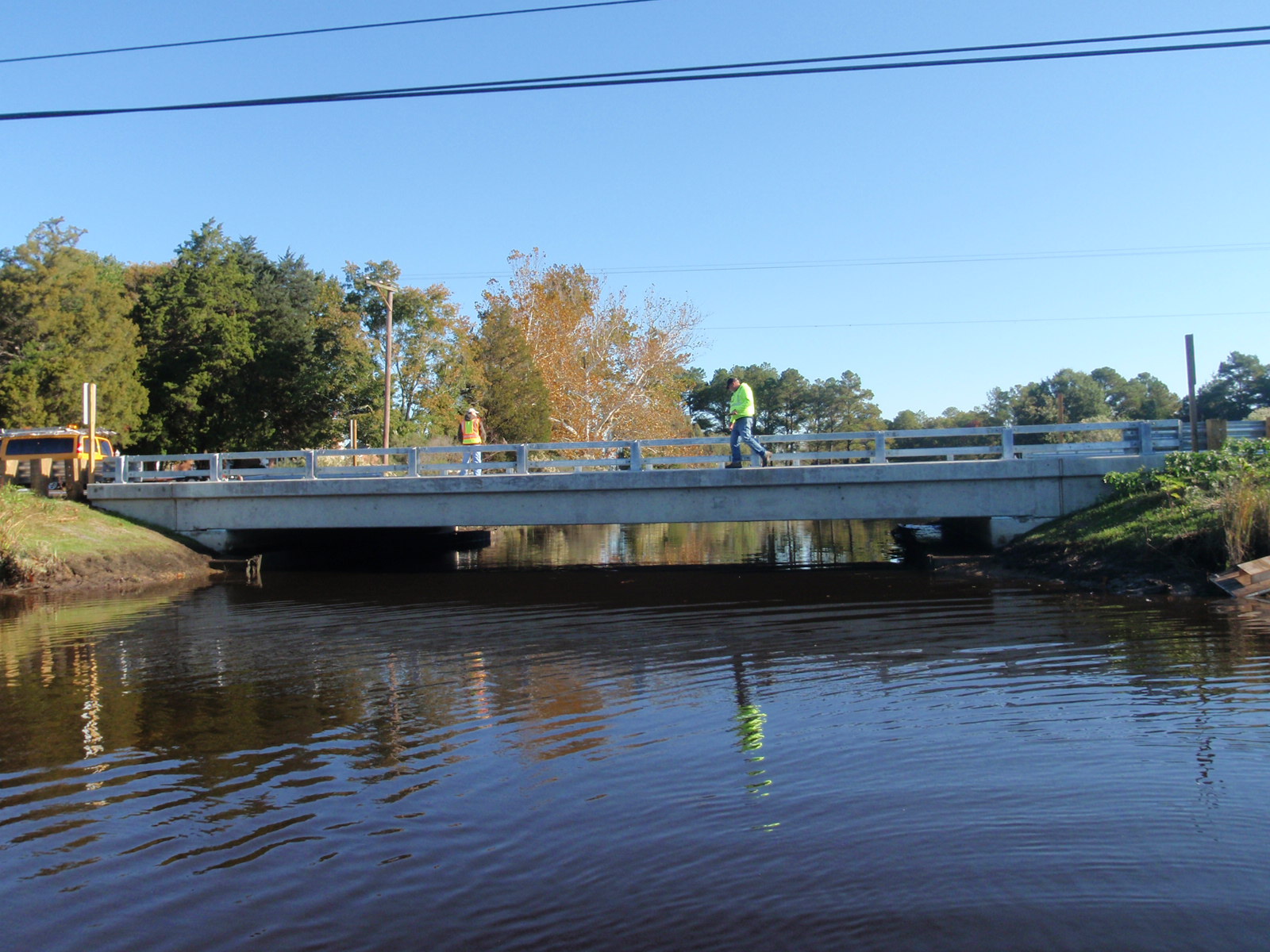

2009 – MD 362 Bridge over Monie Creek
State: MD
Year: 2009
Owner: State
Location: Rural
Beam material: Concrete
Spans: One-span
Max Span Length (ft.): 55
Total Bridge Length (ft.): 55
Impact Category: Tier 5 (within 3 months)
Construction Equipment Category: Conventional
Project Planning: design-bid-build,
full lane closure, incentive / disincentive clause
Geotechnical Solutions:
Structural Solutions: adjacent slab beam, precast abutment cap, precast wingwall, steel sheet piling,
precast curb, CIP reinforced closure joint, grouted key closure joint, bars in splice coupler, PT ducts/bonded, socket connection (in precast substructure)-(caps), latex-modified overlay

2009 – Inyan Kara Creek Bridge
State: WY
Year: 2009
Owner: Crook County
Location: Rural
Beam material: Concrete
Spans: One-span
Max Span Length (ft.): 85
Total Bridge Length (ft.): 85
Impact Category: Tier 5 (within 3 months)
Construction Equipment Category: Conventional
Project Planning: design-bid-build,
full lane closure
Geotechnical Solutions:
Structural Solutions: adjacent deck bulb T beam, precast abutment cap, precast backwall, precast wingwall,
grouted key closure joint

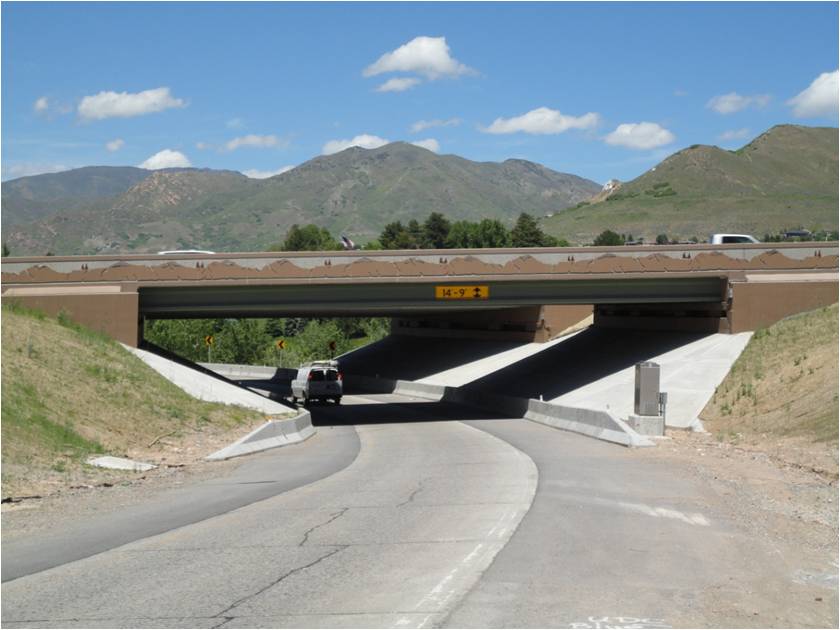

2009 – I-80 Bridge over 2300 East
State: UT
Year: 2009
Owner: State
Location: Urban
Beam material: Concrete
Spans: One-span
Max Span Length (ft.): 80
Total Bridge Length (ft.): 80
Impact Category: Tier 2 (within 3 days)
Construction Equipment Category: Lateral Slide
Project Planning: State process,
design-build (low bid),
full lane closure; incentive / disincentive clause
Geotechnical Solutions:
Structural Solutions: FDcBc (full-width concrete-decked concrete beam unit),
precast approach slab; LWC deck

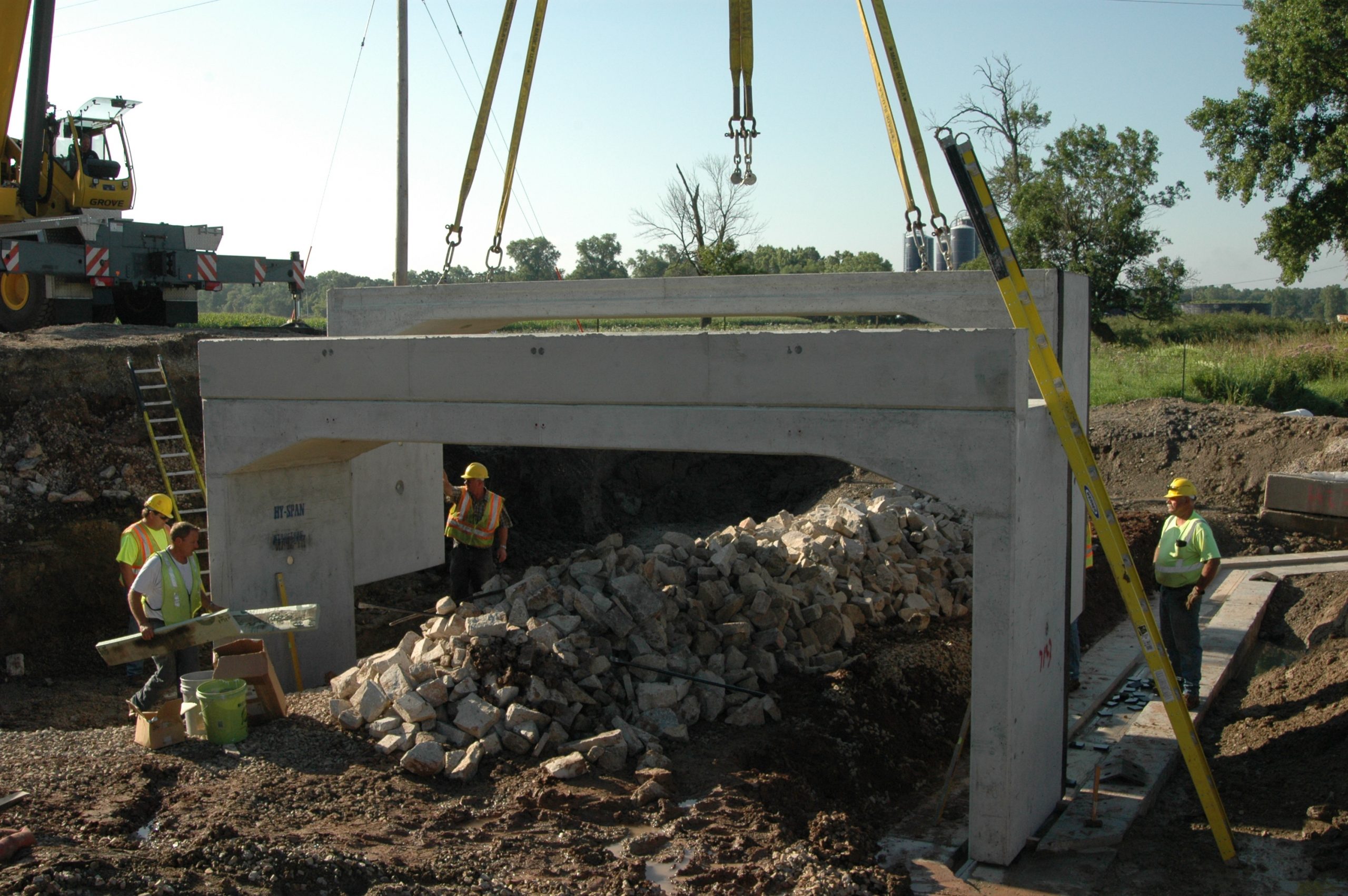

2009 – CTH B Bridge over Parsons Creek
State: WI
Year: 2009
Owner: Fond du Lac County
Location: Rural
Beam material: Concrete
Spans: One-span
Max Span Length (ft.): 21.67
Total Bridge Length (ft.): 21.67
Impact Category: Tier 5 (within 3 months)
Construction Equipment Category: Conventional
Project Planning: In-house force: county crews,
Full lane closure
Geotechnical Solutions:
Structural Solutions: Precast 3-sided culvert; Precast wingwalls,
Grouted key closure joints

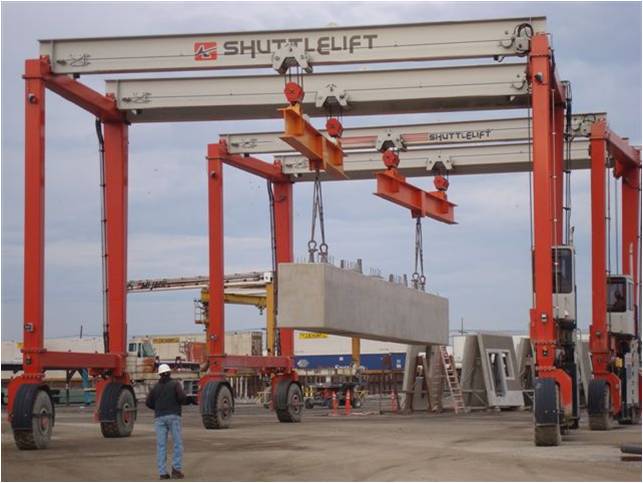

2009 – Black Cat Road Bridge
State: ID
Year: 2009
Owner: State
Location: Urban
Beam material: Concrete
Spans: Two-span
Max Span Length (ft.): 97
Total Bridge Length (ft.): 196
Impact Category: Tier 6 (longer but reduced by months/years)
Construction Equipment Category: Conventional
Project Planning: design-bid-build,
full lane closure, incentive / disincentive clause
Geotechnical Solutions:
Structural Solutions: precast cap & column(s), MSE wall,
bars in splice coupler, grouted duct connection (in precast substructure)

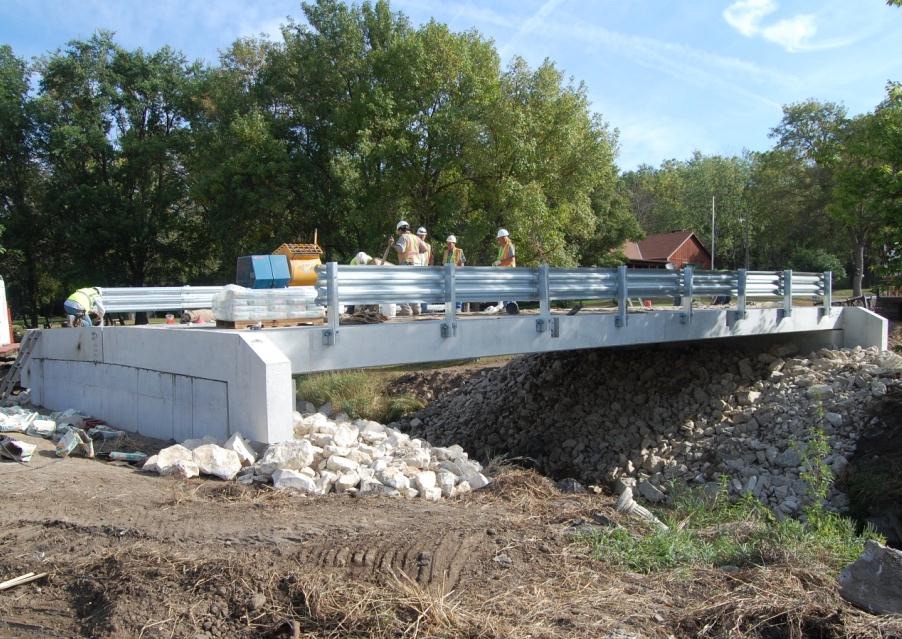

2009 – 640th Street Bridge over Branch Raccoon River
State: IA
Year: 2009
Owner: County
Location: Rural
Beam material: Concrete
Spans: One-span
Max Span Length (ft.): 50.83
Total Bridge Length (ft.): 50.83
Impact Category: Tier 3 (within 2 weeks)
Construction Equipment Category: Conventional
Project Planning: design-bid-build,
full lane closure, incentive / disincentive clause
Geotechnical Solutions:
Structural Solutions: adjacent box beam, precast abutment cap, precast backwall, precast wingwall,
grouted key closure joint, socket connection (in precast substructure), epoxy joint

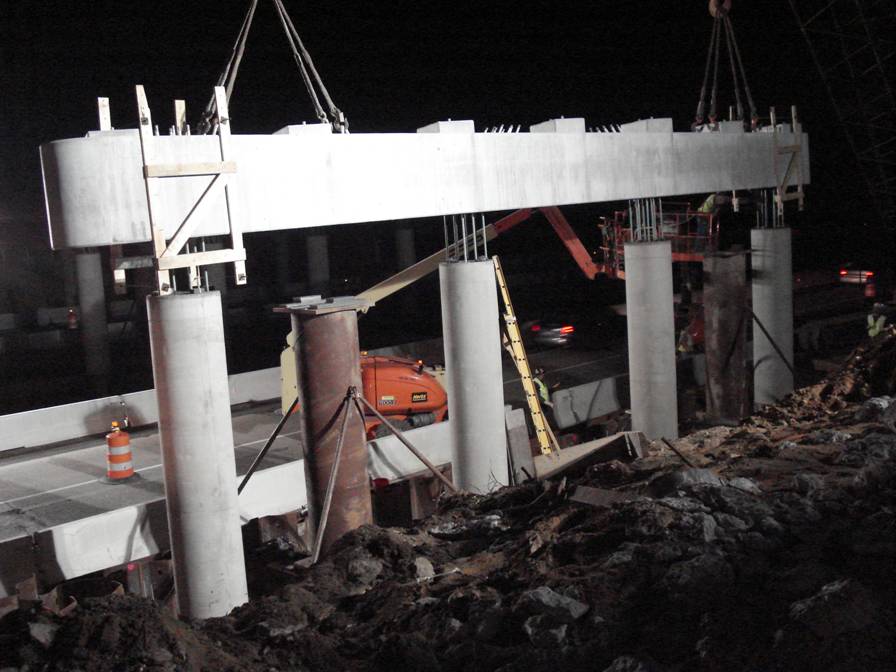

2008 – US 131 / Parkview Avenue Bridge
State: MI
Year: 2008
Owner: State
Location: Urban
Beam material: Concrete
Spans: > Three-span
Max Span Length (ft.): 83.25
Total Bridge Length (ft.): 249
Impact Category: Tier 5 (within 3 months)
Construction Equipment Category: Conventional
Project Planning: design-bid-build,
Geotechnical Solutions:
Structural Solutions: full-depth precast deck panel w/PT, precast cap & column(s), abutment stem,
CIP reinforced closure joint, grouted key closure joint, PT ducts/bonded, grouted blockout w/shear connector, pocket connection (abutment stem to H-piles, pier column to footing, pier cap to column), asphalt overlay w/membrane

2008 – SH 290 Bridge over Live Oak Creek
State: TX
Year: 2008
Owner: State
Location: Rural
Beam material: Concrete
Spans: > Three-span
Max Span Length (ft.): 114
Total Bridge Length (ft.): 700
Impact Category: Tier 6 (longer but reduced by months/years)
Construction Equipment Category: Conventional
Project Planning: Design-Bid-Build,
Geotechnical Solutions:
Structural Solutions: Full-depth precast deck panel w/o PT,
Grouted key closure joint; Grouted blockout w/shear connectors; Asphalt overlay w/o membrane

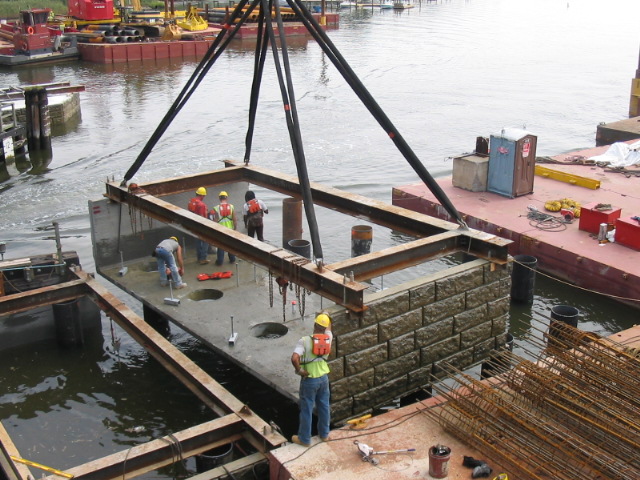

2008 – Route 70 Bridge over Manasquan River (September 11 Memorial Bridge)
State: NJ
Year: 2008
Owner: State
Location: Urban
Beam material: Concrete
Spans: > Three-span
Max Span Length (ft.): 120.25
Total Bridge Length (ft.): 724
Impact Category: Tier 6 (longer but reduced by months/years)
Construction Equipment Category: Other ABC Method
Project Planning: right-of-way acquisition,
design-bid-build,
lane rental, incentive / disincentive clause
Geotechnical Solutions:
Structural Solutions: precast caisson cap, precast cap & column(s), MSE wall,
PT ducts/bonded, prefabricated railing, steel diaphragm, other miscellaneous element – noise wall panel and post

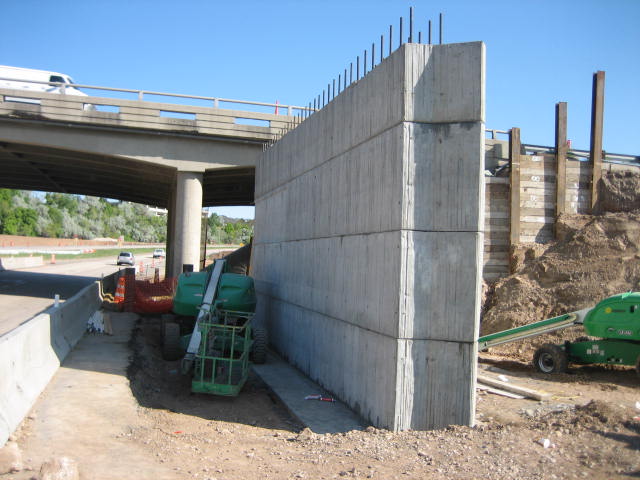

2008 – Riverdale Road Bridge over I-84
State: UT
Year: 2008
Owner: State
Location: Urban
Beam material: Steel
Spans: Two-span
Max Span Length (ft.): 76.5
Total Bridge Length (ft.): 155.5
Impact Category: Tier 1 (within 1 day)
Construction Equipment Category: Conventional
Project Planning: State process,
CM/GC,
full lane closure, incentive / disincentive clause
Geotechnical Solutions: lightweight fill
Structural Solutions: full-depth precast deck panel w/PT, precast cap & column(s), precast abutment stem, MSE wall,
CIP reinforced closure joint, grouted key closure joint, PT ducts/bonded, match cast closure joint, epoxy joint, polymer concrete overlay, precast approach slab, precast diaphragm
