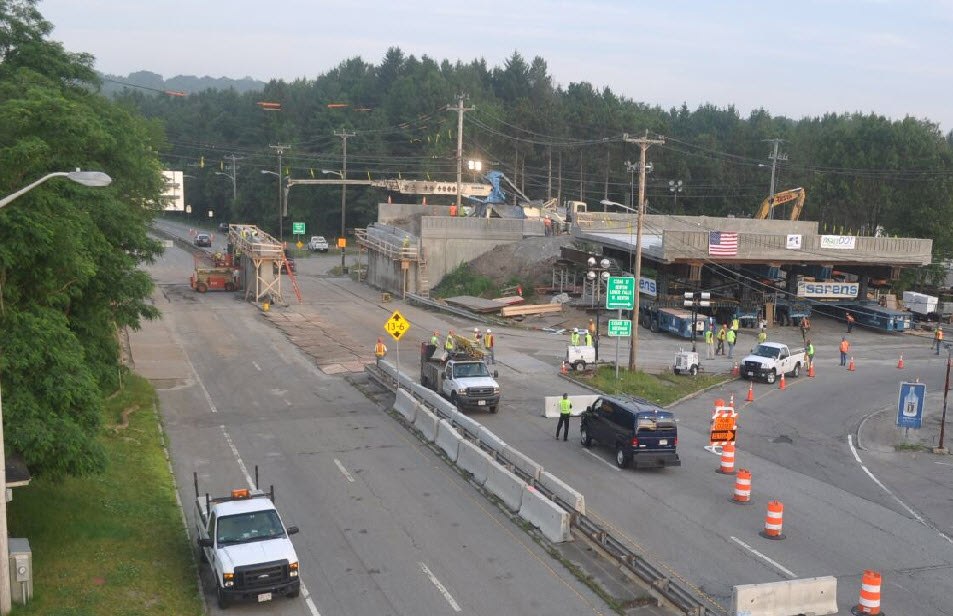

2011 – Cedar Street Bridge (Wellesley)
State: MA
Year: 2011
Owner: State
Location: Urban
Beam material: Steel
Spans: Two-span
Max Span Length (ft.): 41.54
Total Bridge Length (ft.): 83.08
Impact Category: Tier 2 (within 3 days)
Construction Equipment Category: SPMTs
Project Planning: State process, benefit/cost method,
right-of-way acquisition, electronic shop drawing submittal & approval process,
design-build,
full lane closure, incentive / disincentive clause, no excuse bonus, lump sum bonus
Geotechnical Solutions: reused substructure/foundation unit,
Structural Solutions: precast column cap (precast bent cap; precast crossbeam), precast abutment cap,
FDcBs (Full-width concrete-decked steel beam),
precast approach slab, CIP reinforced closure joint, bars in splice coupler, asphalt overlay w/membrane

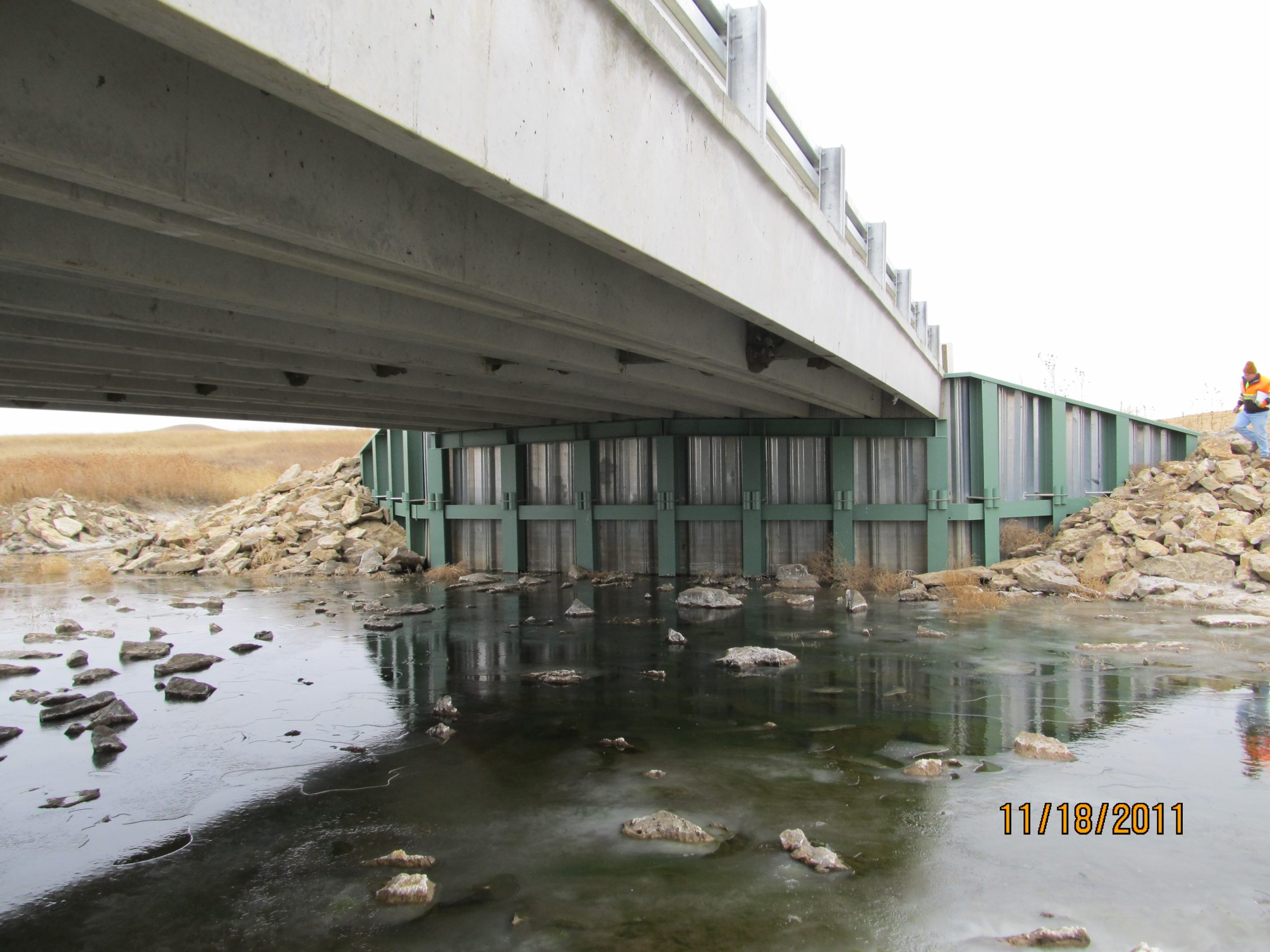

2011 – Buffalo Creek Bridge
State: SD
Year: 2011
Owner: Perkins County
Location: Rural
Beam material: Concrete
Spans: One-span
Max Span Length (ft.): 60
Total Bridge Length (ft.): 60
Impact Category: Tier 6 (longer but reduced by months/years)
Construction Equipment Category: Conventional
Project Planning: Design-bid-build,
Full lane closure
Geotechnical Solutions:
Structural Solutions: Adjacent T beams (double tee); Steel sheet piling; Other abutment and wall element - precast planks,
Grouted key closure joints

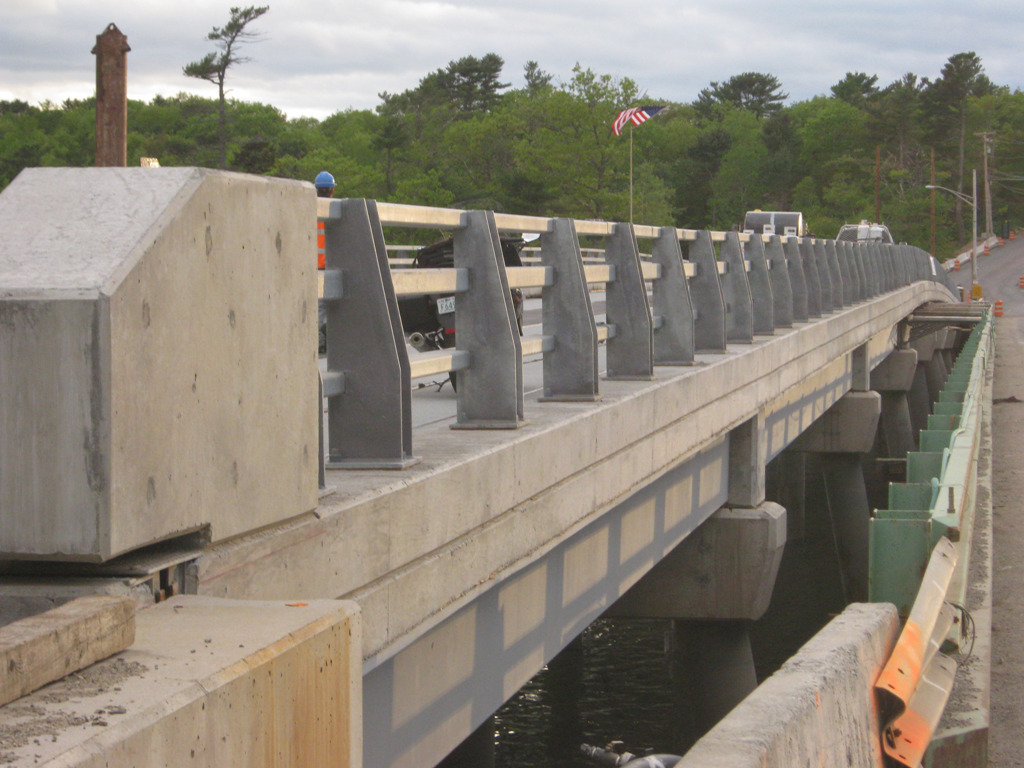

2011 – Boothbay Knickerbocker Bridge
State: ME
Year: 2011
Owner: State
Location: Rural
Beam material: Composite
Spans: > Three-span
Max Span Length (ft.): 70
Total Bridge Length (ft.): 540
Impact Category: Tier 6 (longer but reduced by months/years)
Construction Equipment Category: Conventional
Project Planning: design-bid-build,
full lane closure, lane rental
Geotechnical Solutions:
Structural Solutions: MDcBh (Modular concrete-Decked hybrid Beam - Hybrid Composite Beam (HCB) w/ wings),
asphalt overlay w/membrane

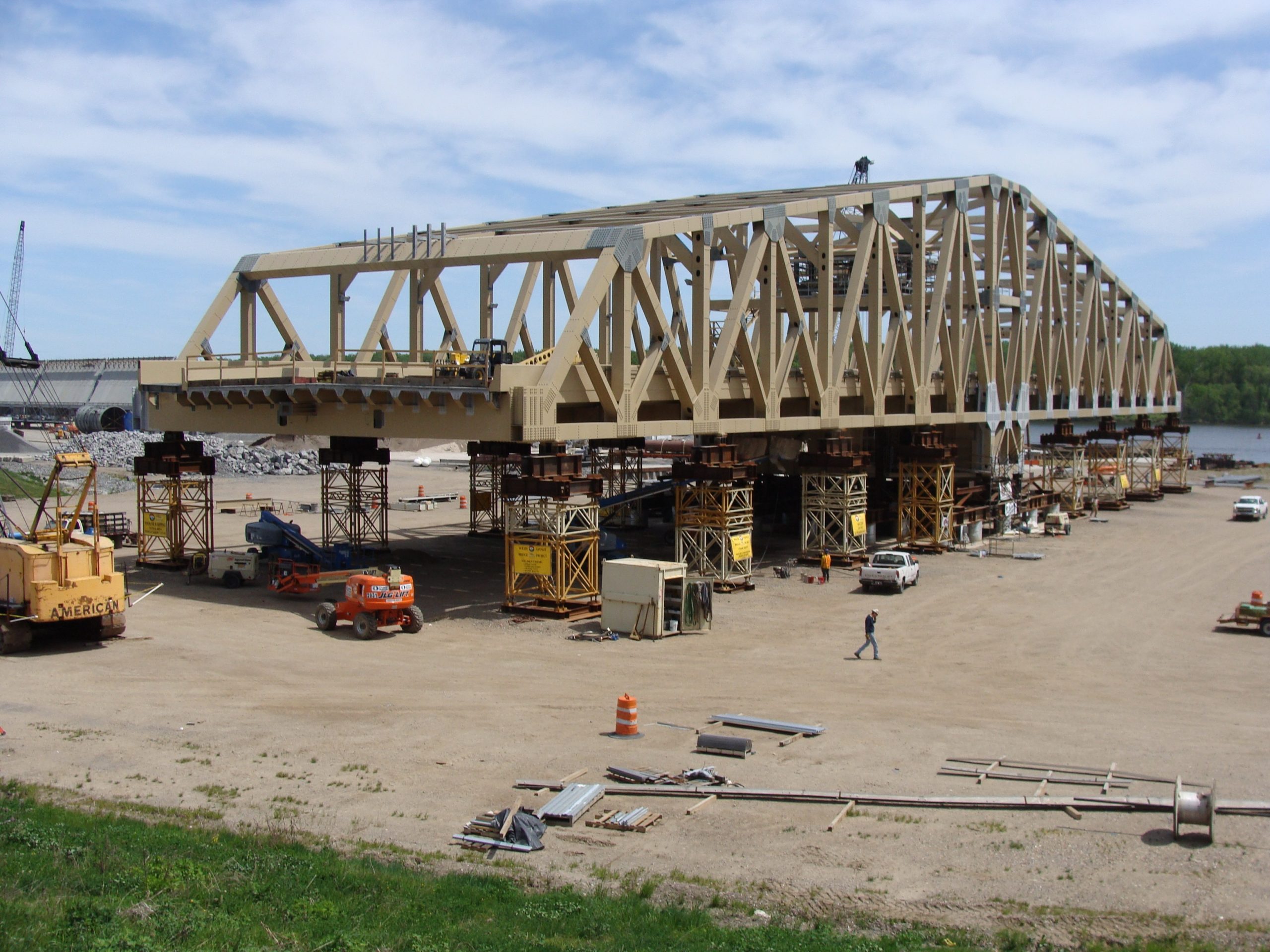

2010 – Willis Avenue Bridge over Harlem River
State: NY
Year: 2010
Owner: New York City
Location: Urban
Beam material: Steel
Spans: > Three-span
Max Span Length (ft.): 350
Total Bridge Length (ft.): 2012
Impact Category: Tier 1 (within 1 day)
Construction Equipment Category: SPMTs
Project Planning: State process; FHWA process,
Right-of-way acquisition,
Design-Bid-Build,
Formalized partnering; Value Engineering
Geotechnical Solutions: Micropiles,
Structural Solutions: Steel grid (concrete filled) deck; Precast cap shells; Steel sheet piling; Precast retaining walls; Modular block walls; MSE walls,
Truss span w/deck,
CIP reinforced concrete closure joints; Grouted key closure joints; Match cast closure joints; Steel diaphragms; LWC deck

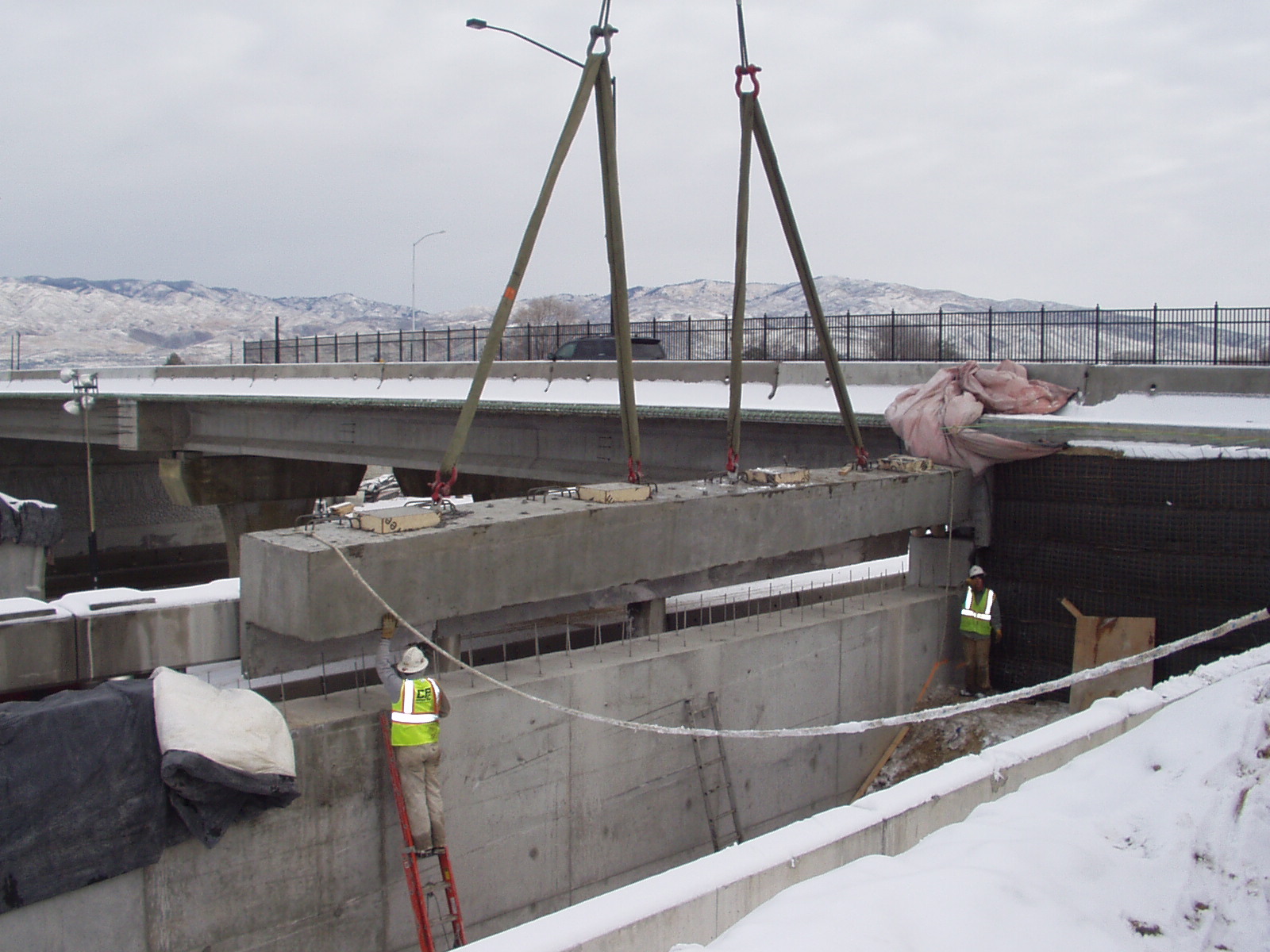

2010 – Vista Interchange Bridge
State: ID
Year: 2010
Owner: State
Location: Urban
Beam material: Concrete
Spans: Two-span
Max Span Length (ft.): 91.5
Total Bridge Length (ft.): 182
Impact Category: Tier 6 (longer but reduced by months/years)
Construction Equipment Category: Conventional
Project Planning: design-bid-build,
lane rental, value engineering
Geotechnical Solutions:
Structural Solutions: precast column cap (precast bent cap; precast crossbeam), precast abutment cap, MSE wall,
bars in splice coupler, grouted duct connection (in precast substructure)

2010 – US 17 Bridge over Tar River (Washington Bypass)
State: NC
Year: 2010
Owner: State
Location: Rural
Beam material: Concrete
Spans: > Three-span
Max Span Length (ft.): 121.67
Total Bridge Length (ft.): 14784
Impact Category: Tier 6 (longer but reduced by months/years)
Construction Equipment Category: Other ABC Method
Project Planning: design-build,
full lane closure, incentive / disincentive clause, formalized partnering
Geotechnical Solutions:
Structural Solutions: precast pile cap,
PT ducts/bonded, socket connection (in precast substructure)

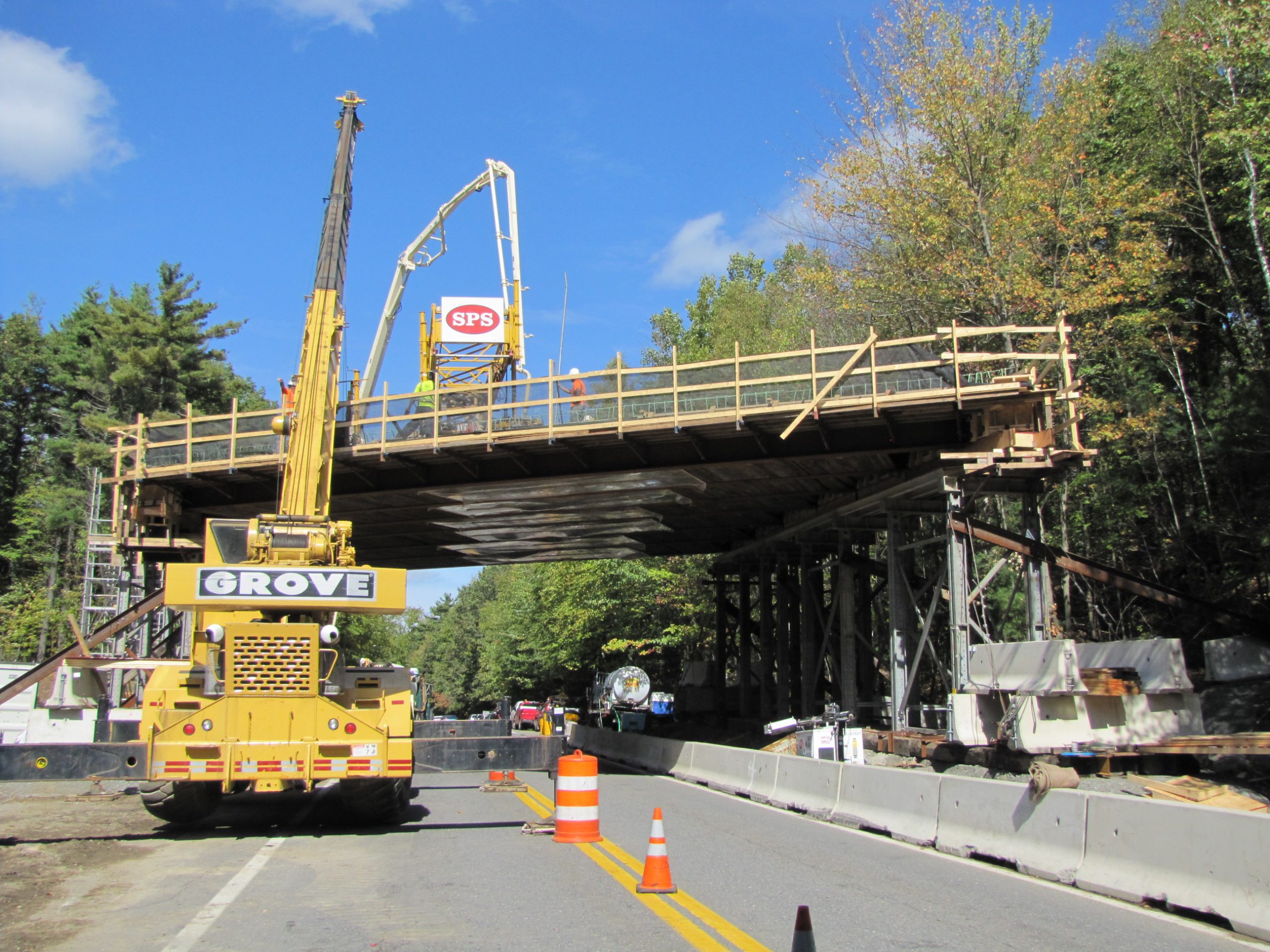

2010 – Phillipston Bridge
State: MA
Year: 2010
Owner: State
Location: Urban
Beam material: Steel
Spans: One-span
Max Span Length (ft.): 60.67
Total Bridge Length (ft.): 60.67
Impact Category: Tier 3 (within 2 weeks)
Construction Equipment Category: SPMTs
Project Planning: State process,
electronic shop drawing submittal & approval process,
design-build,
full lane closure, incentive / disincentive clause, no excuse bonus, lump sum bonus
Geotechnical Solutions: reused substructure/foundation unit,
Structural Solutions: precast abutment cap w/backwall,
FDcBs (Full-width decked beam),
grouted duct connection, asphalt overlay w/membrane

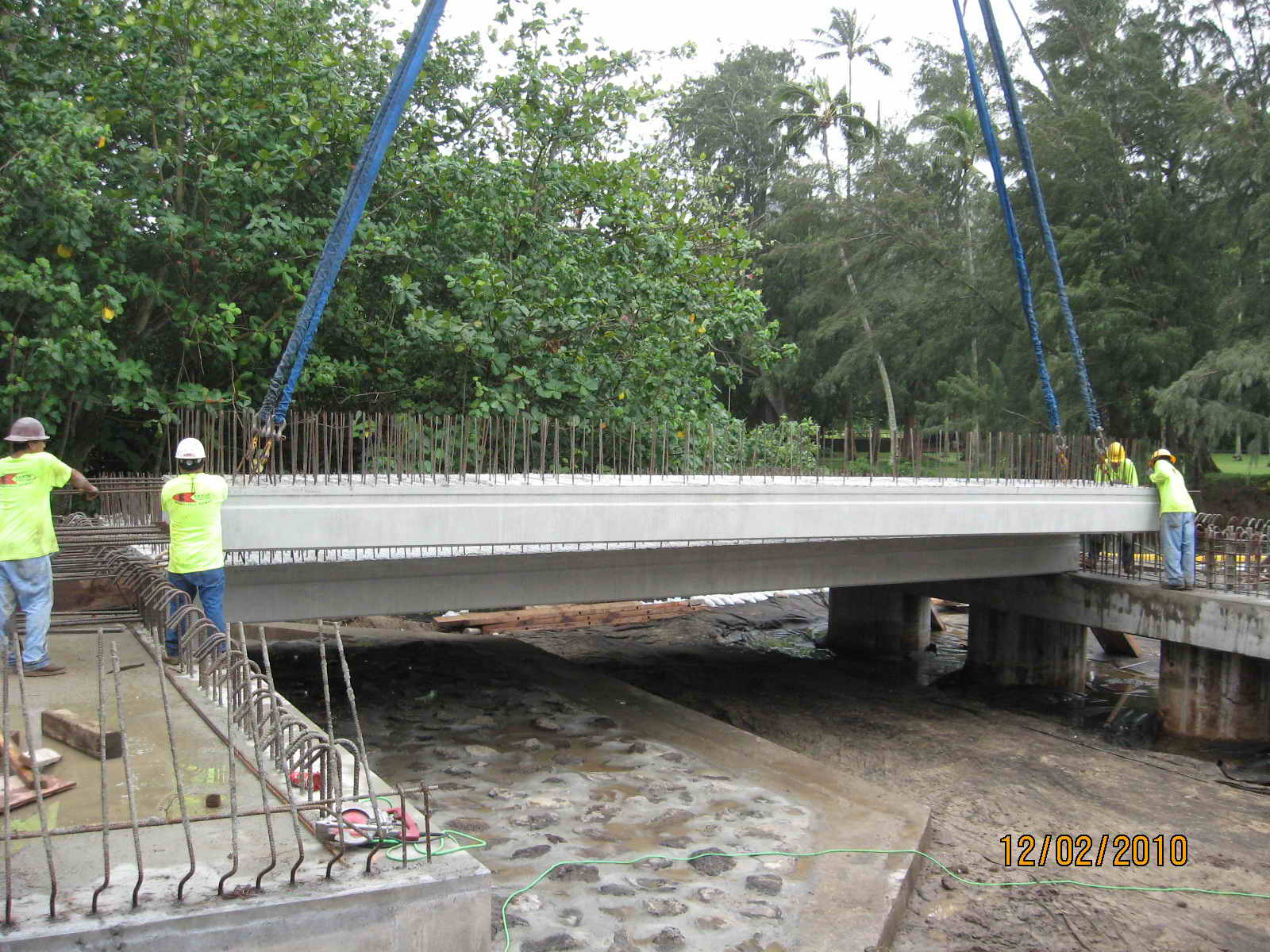

2010 – North Kahana Stream Bridge
State: HI
Year: 2010
Owner: State
Location: Rural
Beam material: Concrete
Spans: Three-span
Max Span Length (ft.): 46
Total Bridge Length (ft.): 128
Impact Category: Tier 6 (longer but reduced by months/years)
Construction Equipment Category: Conventional
Project Planning: design-bid-build,
full lane closure, lane rental, incentive / disincentive clause
Geotechnical Solutions:
Structural Solutions: adjacent slab beam,
grouted key closure joint

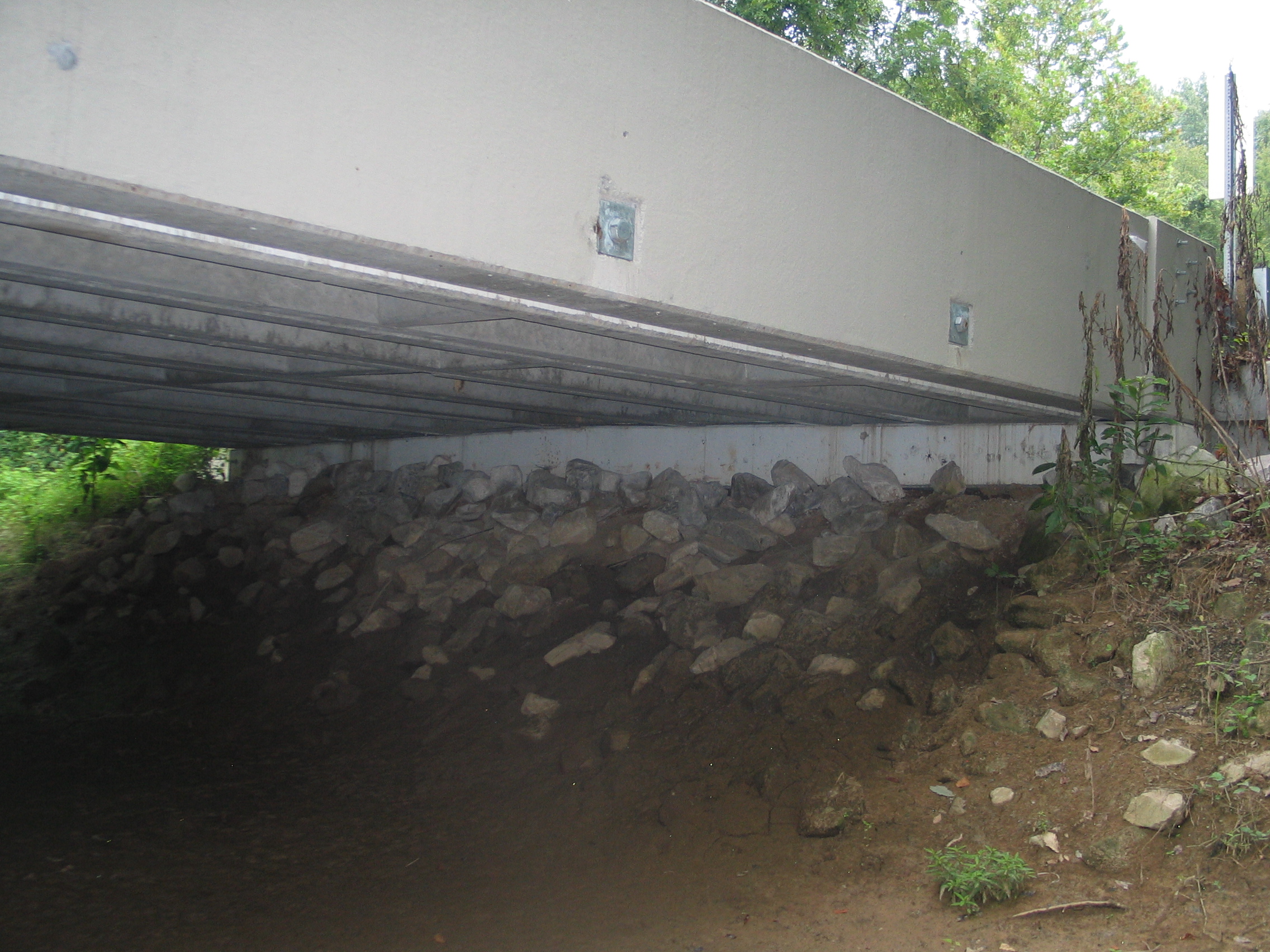

2010 – Kickapoo Bridge
State: MS
Year: 2010
Owner: City of Clinton
Location: Rural
Beam material: Concrete
Spans: > Three-span
Max Span Length (ft.): 31
Total Bridge Length (ft.): 124
Impact Category: Tier 5 (within 3 months)
Construction Equipment Category: Conventional
Project Planning: design-bid-build,
full lane closure, incentive / disincentive clause
Geotechnical Solutions:
Structural Solutions: adjacent slab beam, precast pile cap, precast abutment cap, precast wingwall,
prefabricated railing, grouted key closure joint, socket connection (in precast substructure)

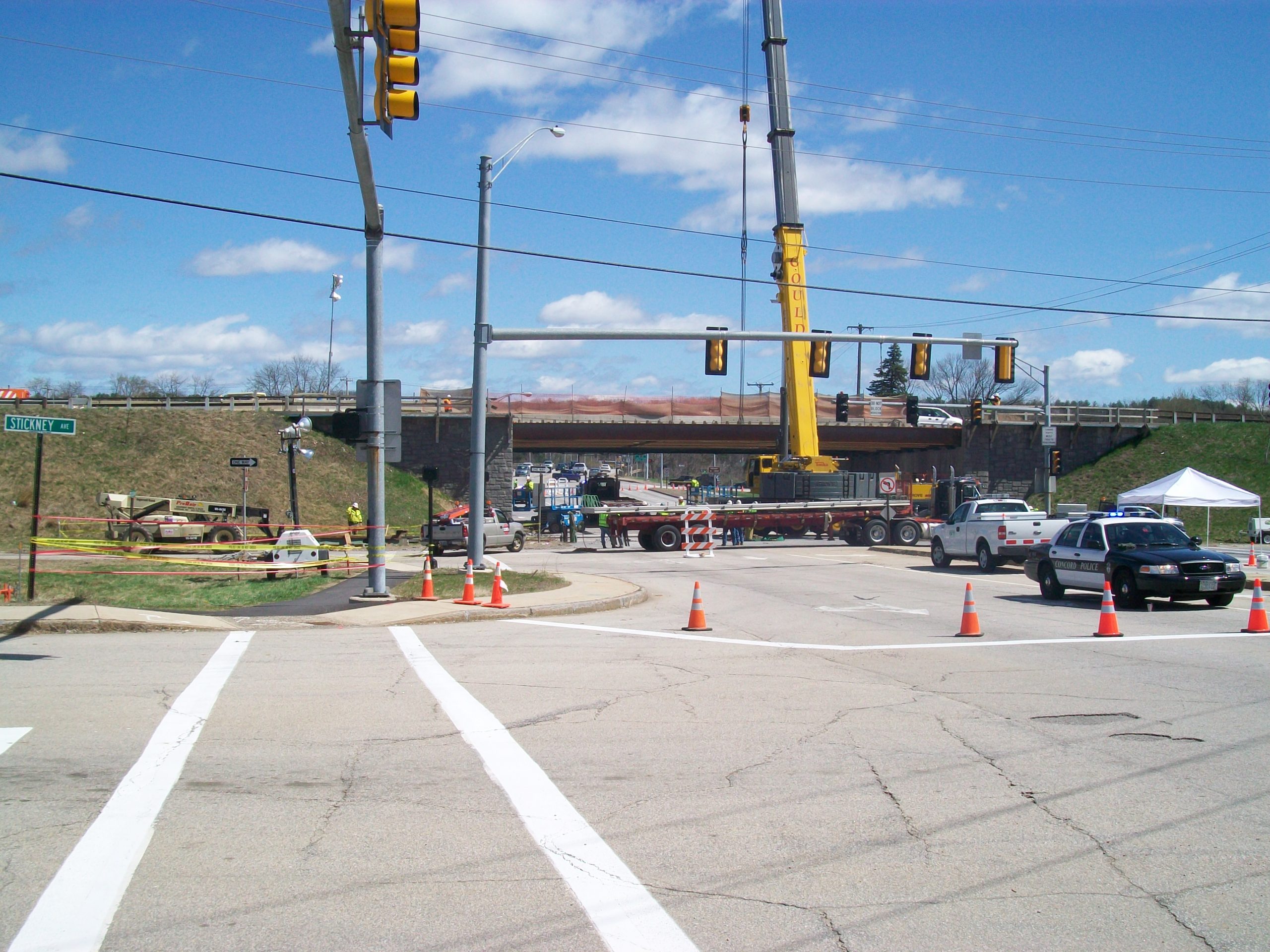

2010 – I-93 Bridge over Loudon Road (Route 9)
State: NH
Year: 2010
Owner: State
Location: Urban
Beam material: Steel
Spans: One-span
Max Span Length (ft.): 82
Total Bridge Length (ft.): 82
Impact Category: Tier 2 (within 3 days)
Construction Equipment Category: Conventional
Project Planning: State process,
design-bid-build,
incentive / disincentive clause, no excuse bonus, value engineering
Geotechnical Solutions:
Structural Solutions: full-depth precast deck panel w/PT,
CIP reinforced closure joint, grouted key closure joint, PT ducts/bonded, asphalt overlay w/membrane
